In January 2000 the PCI Journal described the Bang Na Expressway as the longest bridge in the world, ahead of the 38 km Lake Pontchartrain Causeway in Louisiana. Longer viaducts have since been built, among them the 164.8 km Danyang–Kunshan Grand Bridge in China, which opened in 2011, so the title no longer stands. What has lasted is the method.
The elevated expressway runs for about 55 km above Highway 34 in Bangkok, with a deck area of about 1.9 million m². The owner was Thailand’s Expressway and Rapid Transit Authority; Bilfinger + Berger and Ch. Karnchang built it as a joint venture. Jean Muller International designed the columns and superstructure; the paper credits Asian Engineering Consultants with the alignment and foundations. The contract was signed in June 1995 and allowed 3½ years, with construction starting while design was still under way. One condition shaped everything else: traffic on the highway below had to keep flowing at 80 km/h.

Source: Brockmann & Rogenhofer, PCI Journal, January–February 2000. Diagram: EE&HL Network, 2026.

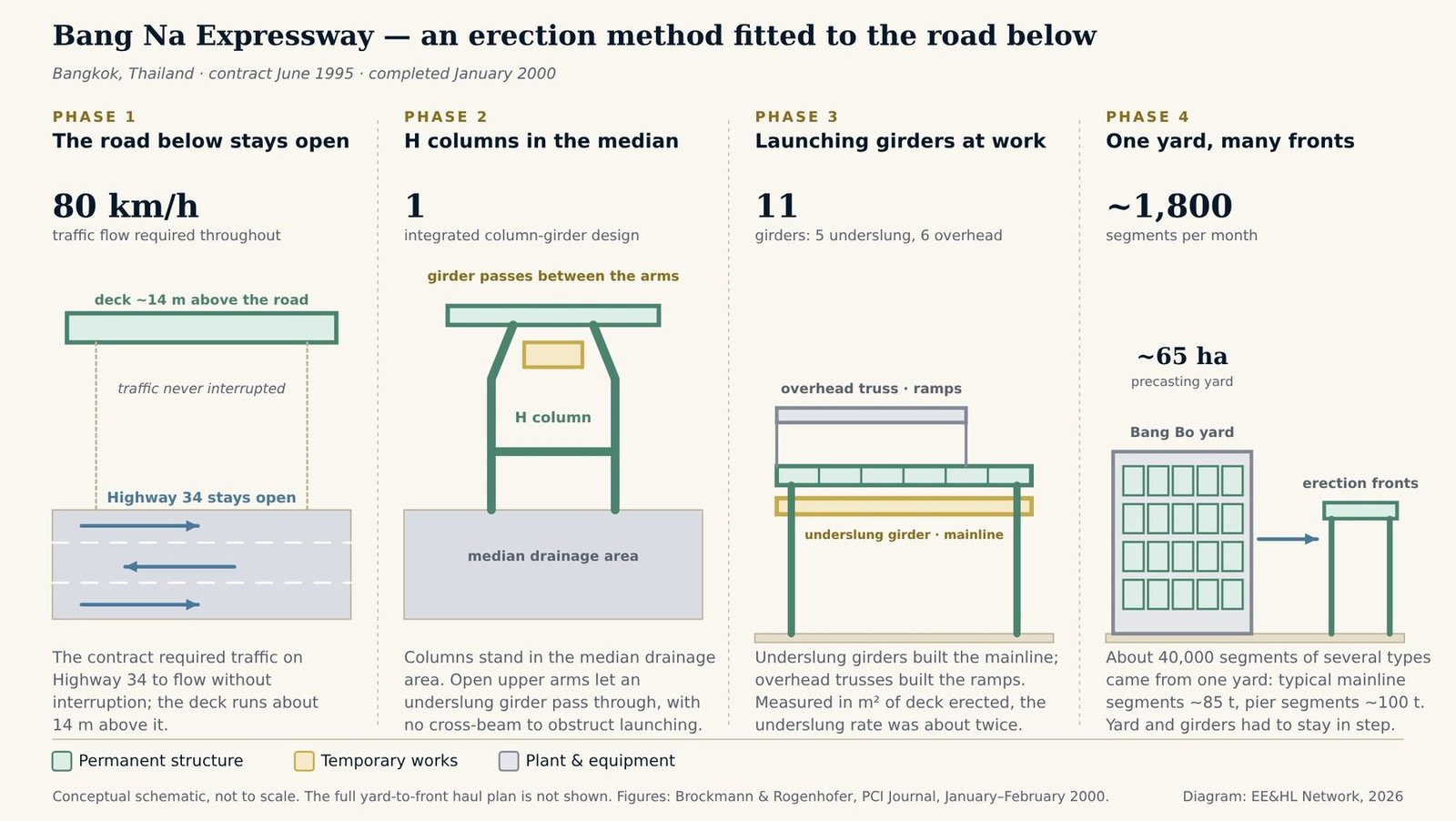

At this scale the erection method is also a logistics contract: casting rate, delivery and girder cycle have to stay locked together on every front.
The PCI article explains that segments were delivered at grade or onto the erected deck and then handled by crane or transport chassis, but the full yard-to-front haul plan is not detailed, and nor is how cycle times were managed, so that part of the picture is not covered here. What it does show is a structure and a method designed together, with column, girder and segment by one designer, around a traffic condition fixed in the contract.
That is the commercial pattern worth noting. A method that only works if casting rate, delivery windows and girder cycle stay locked together carries a commercial dependency as well as a technical one: when one of the three drifts, several fronts that draw on the same yard can be affected. This is an editorial reading; the PCI article does not discuss how that risk was allocated.
For the techniques involved, see What Is Match-Casting? and What Is a Launching Gantry?. For the wider pattern at viaduct scale, see the insight When the Erection Method Becomes the Project. For the sector context, see Erection Engineering in Bridge Construction.
Related case studies: Millau Viaduct · Oléron Viaduct · Woronora River Bridge · Sidu River Bridge · Skarnsund Bridge
Core concepts: What is erection engineering? · What is heavy lift engineering?

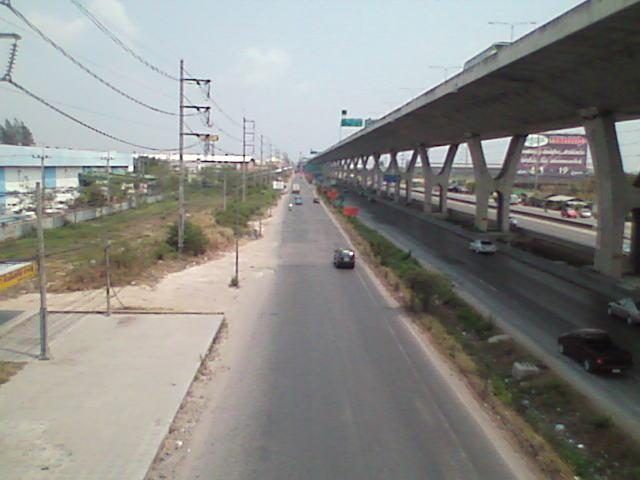

Photo: Miniwildebeest, via Wikimedia Commons; public domain.
Sources: PCI Journal — Brockmann, C. and Rogenhofer, H., “Bang Na Expressway, Bangkok, Thailand — World’s Longest Bridge and Largest Precasting Operation”, January–February 2000, pp. 26–38 (length, deck area, contract, traffic condition, H columns, girders, segments, yard, record claim); Wikipedia — Bang Na Expressway — joint venture, opening date; Wikipedia — Danyang–Kunshan Grand Bridge — length and 2011 record. Span counts and the cycle time per span are not stated in the PCI article and are not given here. The “longest bridge in the world” description is the article’s own, as of January 2000.
Frequently Asked Questions
No. The PCI Journal described it in January 2000 as the longest bridge in the world, ahead of the 38 km Lake Pontchartrain Causeway. Longer viaducts have since been built; the Danyang–Kunshan Grand Bridge in China, at 164.8 km, opened in 2011.
The deck was erected span by span from launching girders running on the structure itself, so no erection work needed the highway closed. The contract required traffic to flow without interruption at 80 km/h. Five underslung girders built the mainline and six overhead trusses built the ramps.
In span-by-span construction a whole span is assembled from precast segments held by a launching girder and post-tensioned, and the girder then advances to the next span. At Bang Na the segments were match cast and joined with dry joints and external tendons.
The PCI article gives two reasons: an H-shaped column takes up the least of the free-flow channel in the median of Highway 34, and with no cross-beam above the girder an underslung girder can move through the column’s upper arms, which simplifies launching.
Jean Muller International designed the columns and superstructure, and the PCI paper credits Asian Engineering Consultants with the alignment and foundations. A joint venture of Bilfinger + Berger and Ch. Karnchang built it for Thailand’s Expressway and Rapid Transit Authority, under a contract signed in June 1995.
