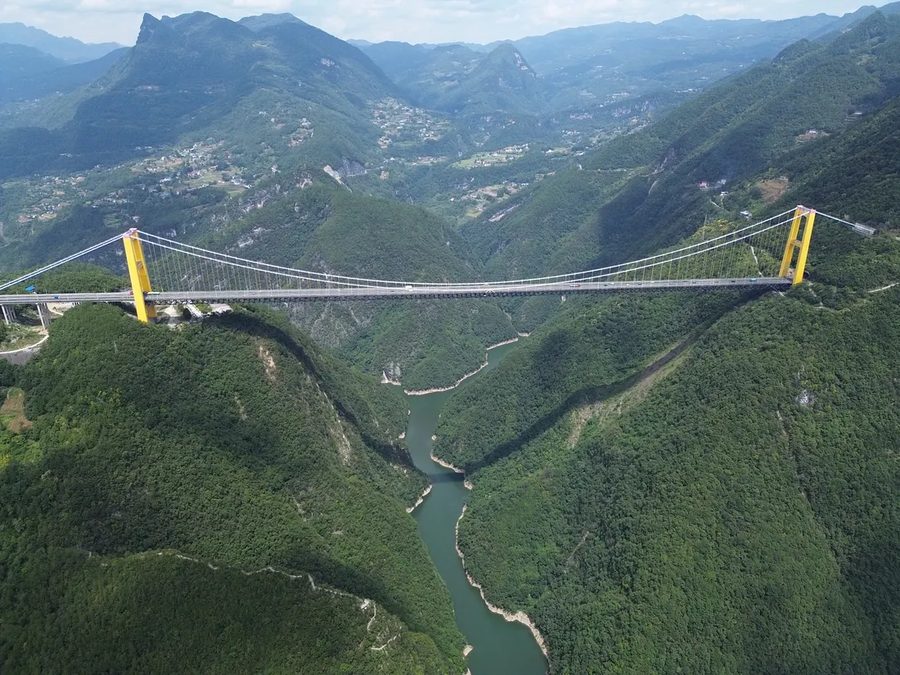

In October 2006, on a mountainside in western Hubei, a team fired two rockets across a canyon. Each trailed a rope of chinlon — an elastic nylon yarn — roughly 1,300 m of it, across a gap of approximately 1,100 m. About ten seconds later the ropes lay on the far slope, close to where they were meant to land. Those two lines were the first physical connection between the two sides of what opened in 2009 as the Sidu River Bridge — the highest bridge in the world at the time, its deck reported at roughly 496–500 m above the river depending on source.
The rockets are the part people remember, and it appears to be the first documented use of one to place a bridge's pilot line. But the detail worth sitting with is not the rockets themselves — it is why they were needed at all.
The operation with the least material in it was carrying a disproportionate share of the sequence's risk — and it sat first, before anything else could begin.


Photo: Glabb / Wikimedia Commons, CC BY-SA 3.0.
None of the individual elements of the launch system was exotic in isolation; what made it necessary was that the terrain had removed the ordinary fallbacks from the cheapest task on the site. The Sidu River Bridge went on to open to traffic on 15 November 2009, holding the record as the world's highest bridge until 2016. Reported figures for its deck height vary by source (approximately 496–550 m), reflecting different measurement points rather than a single confirmed number.
For related context on erection sequencing where conventional methods aren't available, see the EE&HL case study on Akashi Kyō Bridge. For the wider sector context, see Erection Engineering in Bridge Construction.
Related case studies: Akashi Kyō Bridge · Sheikh Zayed Bridge · Millau Viaduct
Sources: Wikipedia — consolidated record citing Chongxu Wang et al.'s account in Civil Engineering alongside other published figures; underlying Civil Engineering reporting by Wang, Peng and Liu on the rocket-launch trajectory model and landing accuracy, as summarised in secondary trade coverage. Deck-height figures differ by source (496 m, 500 m and 550 m have each been published) depending on measurement basis; none is treated here as the single confirmed figure. The launch date is also given two ways in the secondary record itself — 6 October in narrative text versus 9 October in a direct quotation of the underlying Wang, Peng & Liu paper; this page follows the primary-source quotation.
Frequently Asked Questions
The river runs at the bottom of a gorge that engineers judged too deep and too enclosed for a boat to place a line across the roughly 1,100 m span the towers needed, and the winds funnelling through the valley made helicopter work unsafe. With no practical ground route either, the ordinary methods used to string a pilot line on most bridge sites were unavailable, so a rocket-launch system was designed instead.
A pilot line is the first, lightest connection strung across a gap during bridge construction. Everything heavier is drawn across using it in sequence: a hauling line first, then progressively heavier ropes and cables, and eventually the strands that form the main suspension cables. On most crossings it is a minor, low-cost step; at Sidu, the terrain removed the usual fallbacks, making it the operation that decided whether the bridge could be started at all.

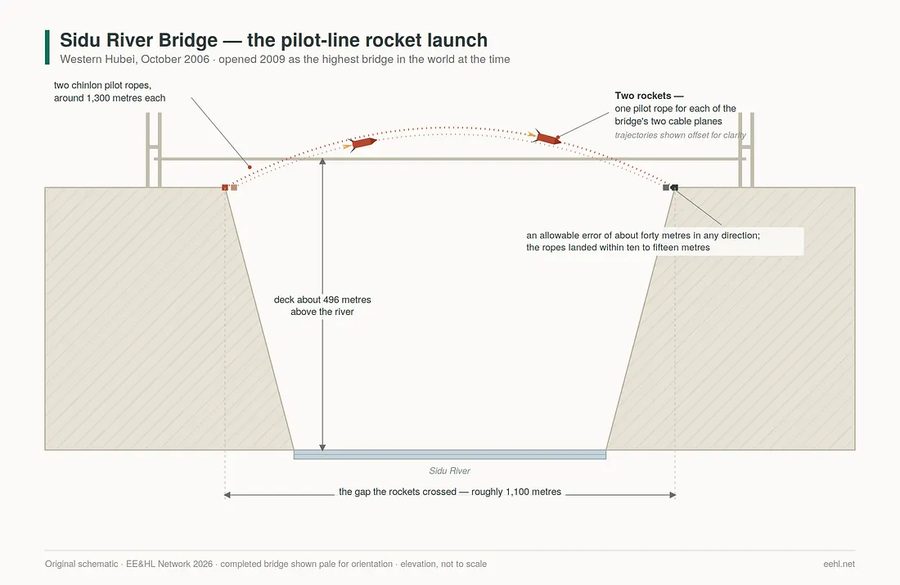

On 9 October 2006, two rockets were fired to carry two ropes made of chinlon, an elastic nylon yarn, roughly 1,300 m in length, across a gap of approximately 1,100 m — one rope for each of the bridge's two cable planes. The allowable landing error was about 40 m in any direction; the ropes landed within 10 to 15 m of their intended positions, guided by a trajectory model that accounted for wind and temperature.
The Sidu River Bridge opened to traffic on 15 November 2009 as the highest bridge in the world at the time. Its deck height above the river has been reported differently across sources — approximately 496 m, 500 m and 550 m depending on the source and how the measurement was taken — and it held the record until 2016.
Risk on large structures tends to be discussed in proportion to a task's size or cost, with heavier lifts and closure operations attracting the most scrutiny. What the Sidu pilot line shows is that the exposure that matters often follows whether an operation has a workable fallback if it fails, rather than how much material or cost it involves — and a task can be cheap and still have no ordinary alternative behind it.
