Concrete Gravity Base · Continuous Slipforming · Coordinated Tow-Out
Towing the Heaviest Object Ever Moved by Humans — Gullfaks C, North Sea (1989)
North Sea, NorwayConcrete Gravity Base Structure Tow-OutTowed 1989
1.4 million tonnes. The heaviest object ever moved wasn't lifted. It was towed.
In 1989, Gullfaks C displaced 1.4 million tonnes of water as it moved to its North Sea location — still the Guinness World Record for the heaviest man-made object ever relocated. Getting there required solving two entirely different engineering problems: how to build a structure of that mass without it failing under its own weight during construction, and how to move it without any precedent to draw on.
1.4M t
Water displaced
262 m
Height before topsides
~1 knot
Tow-out speed
216 m
Ballasted tow depth
Phase 1 — Continuous slipforming
A sequencing problem with no room for error
Gullfaks C is a CONDEEP — a concrete gravity base structure — slipformed continuously with no cold joints, integrated by Aker Stord, reaching 262 m before topsides were added. Pour too fast, and the concrete can't yet carry the load above it. Pour too slow, and the formwork bonds. At this scale, that margin becomes structural.
Phase 2 — No piles, no anchors
Mass and geometry do the work
As a CONDEEP structure, Gullfaks C was never designed to be piled or anchored into the seabed. Its own mass and geometry hold it in position once installed — a design principle that shaped not just the final structure, but how it had to be built and moved before installation ever began.
Phase 3 — The coordinated tow-out
Control, not force
Moving the structure was never about generating enough force — it was about control. Tugboats operated in coordinated formation at roughly 1 knot, navigating fjord passages with minimal clearance, while controlled ballasting brought the structure to a tow depth of 216 m.
Phase 4 — Preventing yaw, not correcting it
Every tug carrying a defined load
Each tug in the formation carried a precisely defined load. If any single tug lost tension, yaw would begin — and at this mass, yaw could not be corrected once it started. It could only be prevented, through the discipline of the formation itself.
No precedent. Only constraints. The method emerged from solving them.
Gullfaks C stands as a reference case for heavy transport at the absolute limits of scale: a record that has stood since 1989 not because the physics were unusual, but because so few structures have ever combined this much mass with this little margin for correction once underway.

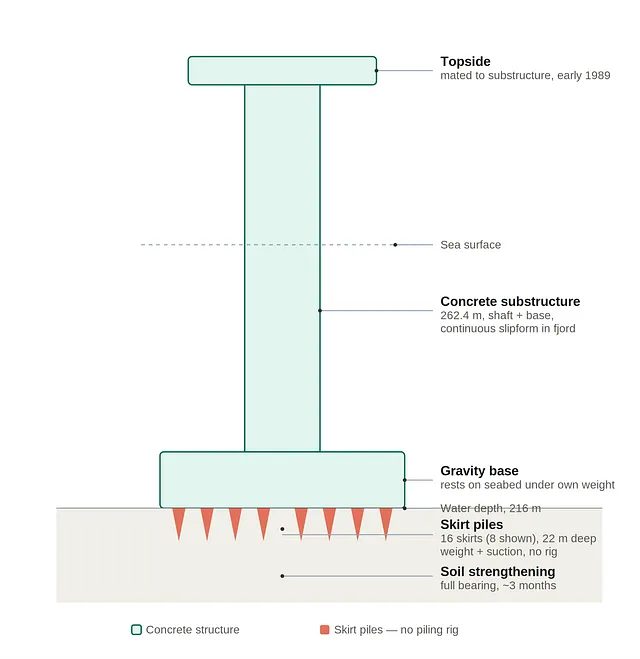

Gullfaks A being completed at the Kværner Yard, Stord, Norway, 1988 — a sister Condeep platform in the same series as Gullfaks C, constructed using the same slipformed gravity-base methodology. Photo: rodjonesphotography.co.uk, CC BY 2.0.Gullfaks C — installed cross-section: topside, concrete substructure (262.4 m, slipformed continuously in a Norwegian fjord), and sixteen skirt piles driven 22 m into the seabed by platform weight and suction rather than a piling rig. Original diagram, EE&HL Network, 2026.
Sources:Gullfaks oil field — platform data and displacement; Troll A platform — documents the distinction between the heaviest object moved (Gullfaks C, approaching 1.5 million tonnes displacement) and the tallest (Troll A). Figures are reported as published.
