The Sheikh Zayed Bridge reads as one continuous gesture: three pairs of steel arches sweeping up to roughly 60 m above the Maqta Channel, the whole form drawn from the curve of a desert dune. What the finished structure hides is that almost nothing about erecting it could be repeated.

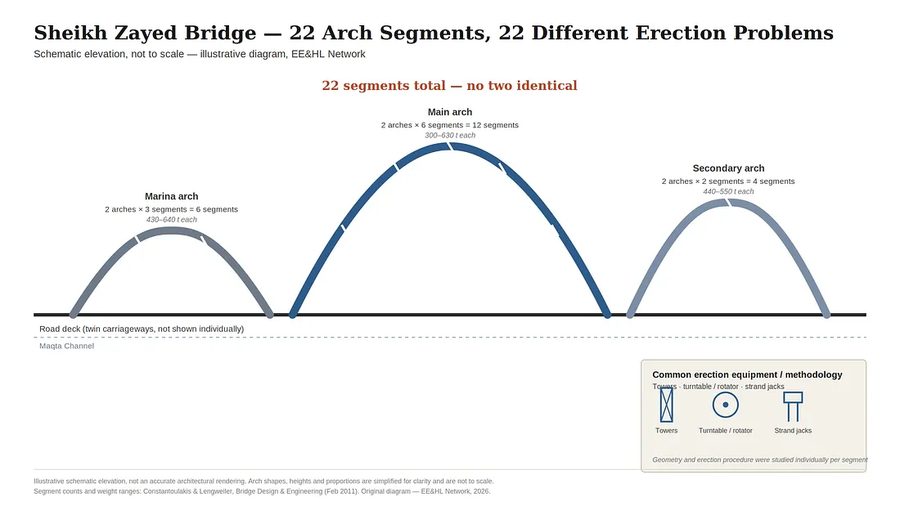

Most large bridges recover their own construction cost through repetition — solve the erection problem once, then repeat the solution span after span. The dune geometry designed by Zaha Hadid removed that option before construction started. The steel arch structure was divided into 22 separate segments, and because the underlying curve never repeats, no two segments shared the same geometry, orientation or erection condition. Each needed its own erection study: its own lifting and rotation sequence, its own temporary support arrangement, its own welding procedure.
Nobody could safely price the erection scope as a single lift-and-repeat exercise, because there was no repeat to base a rate on.
The engineering responsibility for making that work was split three ways. Archirodon Construction (Overseas) Co. S.A., the main contractor, developed the overall erection methodology and construction sequencing. VSL International provided prestressing and erection-related engineering support. Buckland & Taylor Ltd, a Vancouver-based firm working across a substantial time-zone gap from the site, acted as construction engineer — reviewing construction sequence, checking temporary works, and calculating force effects and reactions through every stage of erection. By the firm's own account, approximately 400 changes were made to the permanent design over the course of the project to keep each stage within safe stress limits, and correspondence between the parties ran to roughly 2,000 emails in each direction over the life of the assignment. Six Construct Ltd, part of the BESIX group, carried out the temporary steelwork.


Photo: Валерий Дед (Valeriy Ded), via Wikimedia Commons, CC BY 3.0.
None of the individual techniques here is exotic on its own — heavy falsework, staged modelling and design revisions during construction happen on plenty of complex bridges. What is unusual is that a common erection system carried across most of the 22 segments while the marina arches followed a separate crane-based route of their own — and that, under either method, every segment still required its own detailed study worked out from first principles. Mass concrete pours were completed, by Buckland & Taylor's account, with no detrimental cracking despite ambient temperatures that regularly exceeded 40°C during construction. When the completed bridge was load-tested with a convoy simulating roughly double the normal design load ahead of its November 2010 opening, the structure held within tolerance.
For related erection-engineering context, see the EE&HL case studies on Akashi Kyō Bridge, where planned geometry also had to be revised mid-construction, and Millau Viaduct, another case where method drove design. For the wider sector context, see Erection Engineering in Bridge Construction.
Related case studies: Akashi Kyō Bridge · Millau Viaduct · Sidu River Bridge
Sources: Buckland & Taylor Ltd. — construction engineer's own account of the erection engineering scope, design revisions and load test; Structurae — structural data and contractor/engineer record; Archirodon — main contractor's project record. Published arch heights differ between sources (approximately 60–64 m) depending on whether the figure is measured to the deck or the arch crown.
Frequently Asked Questions
The bridge's dune-inspired geometry means the steel arch structure never repeats itself along its length. Each of the 22 segments across the three arch pairs has its own orientation, curvature and support condition, so no segment's erection sequence could simply be copied from the one before it. Every segment required its own lifting and rotation sequence, temporary support arrangement and welding procedure, worked out from first principles.
Responsibility was split three ways. Archirodon, the main contractor, developed the overall erection methodology and construction sequencing in-house. VSL International provided prestressing and erection-related engineering support. Buckland & Taylor, a Vancouver-based firm, acted as construction engineer, carrying out independent checking, temporary-works review, and detailed construction-stage engineering across the project.
Most segments were erected using dedicated steel towers roughly 60 m tall, working with a travelling turntable and rotator arrangement and strand jacks instrumented to compare each segment's behaviour against the design analysis as it went up. Under programme pressure, the marina arches were erected by a different route: a large crawler crane operating from a purpose-built platform inside a cofferdam.
According to Buckland & Taylor's own account of the project, approximately 400 changes were made to the permanent design during construction to keep every erection stage within safe stress limits. This reflects the absence of a repeatable module rather than errors in the original design — each of the 22 segments had to be checked and, where necessary, adjusted stage by stage.
Before the bridge opened to traffic in November 2010, it was load-tested using a fully loaded convoy of trucks positioned across the deck to simulate roughly double the normal design load. The structure passed within tolerance. The bridge carries a two-way, four-lane highway across the Maqta Channel between Abu Dhabi Island and the mainland.
