In bridge construction and heavy lift, the installation of temporary works gets the engineering attention it deserves: sequencing documents, hold points, monitoring plans. Their removal can receive less of that attention and rest more on assumptions. That asymmetry is worth understanding, because the moment a structure is asked to stand without the supports that got it there can be the moment it is least well described.

This piece looks at why removal is structurally distinct from installation, why treating it as installation run in reverse is a mistake, and what the UK's own procedural framework already says about it.

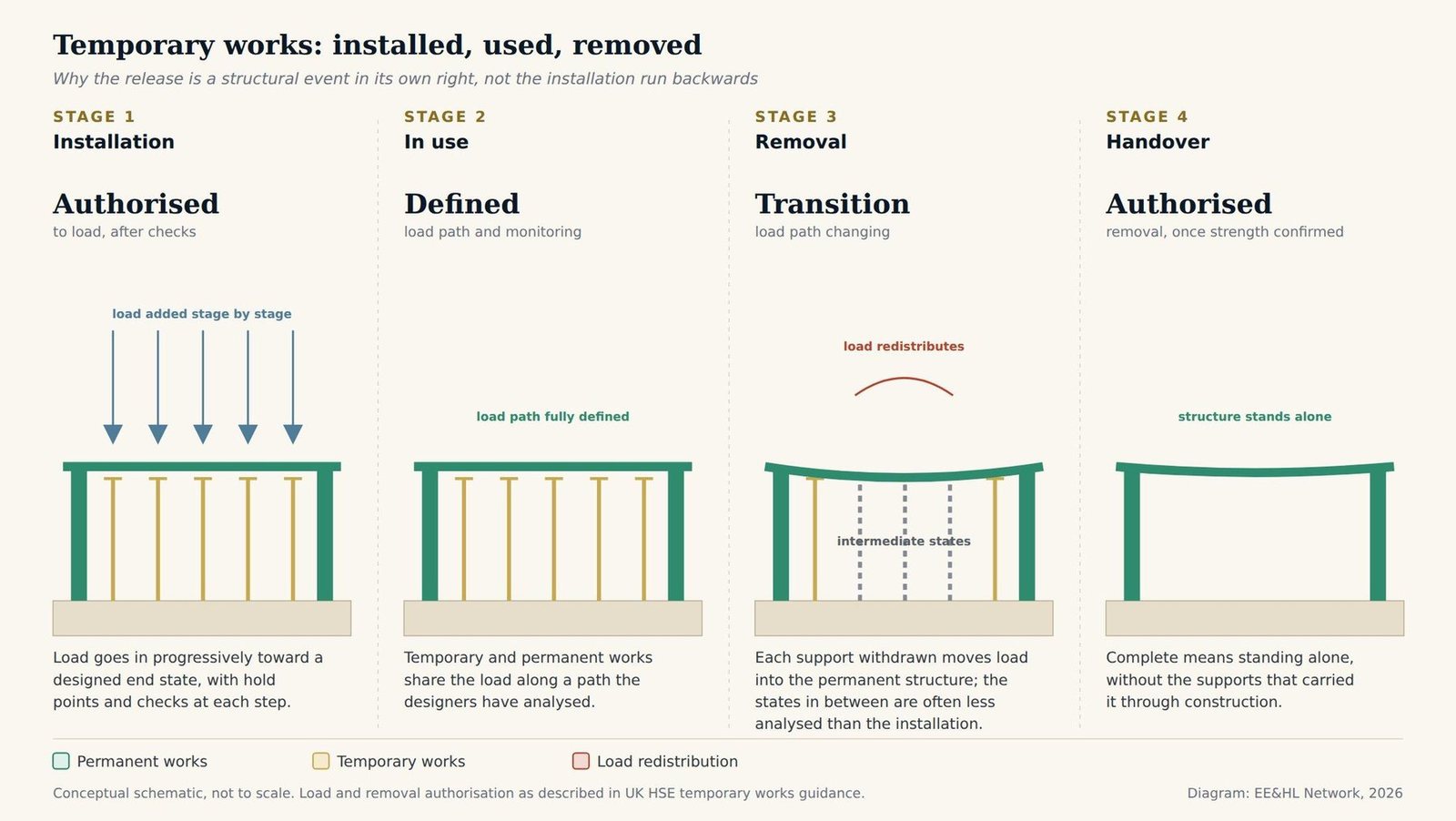

Four-stage schematic of temporary works: installation with load added stage by stage after authorisation to load, the structure in use with a defined load path, removal with supports withdrawn and load redistributing through intermediate states, and handover with the structure standing alone after authorisation to remove
Installation, use, removal, handover. The third stage is the one most at risk of not being analysed in its own right. Conceptual schematic, not to scale. Diagram: EE&HL Network, 2026.

Removal is not installation in reverse

Installation introduces load into a system progressively. Each stage is assessed against the intended construction sequence, and the process builds toward a defined final state.

Removal does something different. It withdraws support from a structure whose behaviour, stiffness and deformed shape have been influenced by the presence of the temporary works. As each support comes out, the load path changes, sometimes substantially, depending on the configuration of the temporary works and the form of the structure. During that transition the structure can pass through intermediate states that were not explicitly checked in the original design: partial redistribution, asymmetric stiffness, local stress concentrations that did not exist at any earlier stage.

Three reasons the removal phase is exposed

1 — The structure
A load path in transition
Installation builds toward a defined end state. Removal passes through states in which the structure is neither fully supported by the temporary works nor fully self-supporting, and these states can be simplified or left implicit in design documentation.
2 — The people
Attention has already moved on
By the time temporary works are stripped out, the structure looks complete. Programme pressure is at its highest, plant and access equipment are waiting to be released, and the engineers who scrutinised the installation may already have moved to the next contract. Removal can then be treated as a routine site activity rather than a structural operation.
3 — The warning signs
Consequences appear late
Problems during installation tend to show themselves early, through unexpected deflection, cracking or misalignment, while there is still support in place. During removal the redistribution happens as the support goes, so the consequences may only become visible after it has already occurred.

What the UK procedure already requires

The UK framework does treat removal as a controlled step. HSE guidance lists authorisation to load and removal among the stages that whoever organises temporary works has to coordinate. HSE's guidance to its own inspectors, written against the 2008 edition of BS 5975, describes the procedure in more detail: the temporary works co-ordinator checks that the works have been erected in accordance with the design and issues a formal permit to load, then confirms when the permanent works have attained adequate strength to allow dismantling and issues a formal permit to dismantle, in each case where necessary. The current standard, BS 5975-1:2024, covers dismantling as a controlled part of the temporary works process. That dismantling was part of the problem from the start is visible in the history: the review of falsework practice that followed the 1972 Loddon Viaduct collapse covered how falsework is designed, erected and dismantled.

The authorisation sets a gate. It confirms that the permanent works are ready to take load. It does not by itself describe the order in which support is withdrawn, the states the structure passes through on the way, or what to watch while it happens. That is where the engineering content of the removal phase sits, and where it is most often thin.

When removal is on the critical path

Removal is also where time and money concentrate. At the Millau Viaduct, the temporary steel towers that carried the deck during launching could not be released until the stay cables had been installed and tensioned. The release condition was set by the stay-cable programme rather than by the erection contractor's own, and dismantling could only follow once it was met. See the Millau Viaduct case study for the full sequence.

The commercial pattern is familiar. Removal releases hired falsework, cranes and access, so every day it takes has a visible cost and there is pressure to strike early. At the same time, the scope of the temporary works designer may have been drawn around erection rather than removal, leaving the withdrawal sequence without a clear owner. The party that pays for the standing plant and the party that decides when it may be released are often not the same.

What a well-controlled removal phase looks like

The practical implication is that the removal sequence deserves the same level of analysis as the installation sequence. That means explicit load cases for each stage of support withdrawal, release criteria defined at design stage rather than on site, hold points tied to structural verification rather than programme milestones, and monitoring that covers the removal phase with the same rigour as the installation.

On complex structures such as long-span bridges, launched decks and offshore load-outs, the removal of temporary works is the last critical structural event before handover. Completion does not only mean that the structure is standing. It means it is standing alone.

For the definitions behind this article, see What is Temporary Works in Construction?, What Is a De-Propping Sequence? and What is Erection Sequence Risk?.

Related case studies: Millau Viaduct · Singapore Sports Hub · Eiffel Tower · Gateway Arch · Beijing National Stadium

Sources: Health and Safety Executive — SIM 02/2010/04, “The management of temporary works in the construction industry”, guidance to inspectors based on BS 5975:2008, archived by The National Archives (permit to load, confirmation of adequate strength, permit to dismantle); Health and Safety Executive — Temporary works FAQs (authorisation to load and removal); BS 5975-1:2024 — Management procedures for the control of temporary works, British Standards Institution; EE&HL Network — Loddon Viaduct and the Bragg report; EE&HL Network — Millau temporary towers release sequence, with its primary sources. An earlier version of this article was published on Medium in June 2026.

Frequently Asked Questions

Removing temporary works withdraws support from a structure whose behaviour during construction was shaped by those supports. Each support taken out moves load into the permanent structure, which passes through intermediate states that are often less thoroughly analysed than the installation sequence. The work also tends to happen when the structure looks finished, programme pressure is high and engineering attention has moved on.

No. Installation introduces load progressively toward a designed end state. Removal takes support away from a structure that has already been loaded, and the load redistributes in ways an installation-focused analysis may not capture. The order and pace of withdrawal need their own checks rather than being read off the installation sequence in reverse.

It is the formal authorisation to remove temporary works. HSE guidance to its inspectors, based on the 2008 edition of BS 5975, describes the temporary works co-ordinator confirming that the permanent works have attained adequate strength to allow dismantling and issuing a permit to dismantle where necessary, as the counterpart of the permit to load. Terminology varies between procedures and editions of the standard; the current edition is BS 5975-1:2024.

A de-propping sequence is the specific order in which temporary supports are removed as a structure becomes self-supporting. This article is about the wider pattern around that sequence: why the removal phase as a whole tends to receive less engineering attention than installation, where the risk and the cost concentrate, and what a well-controlled removal phase looks like.
