The Sphere at The Venetian Resort is 157 m in diameter and 112 m tall. The domed roof alone required 13,000 tonnes of structural steel. It looks like a completed object. During erection, the records show it was something else entirely.

Project documentation describes a spherical diagrid with no complete load path until the compression ring closes. Before that point, every element placed alters the geometry, shifts force distribution, and moves what "correct position" means for the next segment. The structure doesn't passively converge — it accumulates deviation. The first engineering problem wasn't how to build the dome. It was how to hold it in a condition that didn't yet exist.

157 m
Sphere diameter
112 m
Sphere height
13,000 t
Roof structural steel
368
Cast steel nodes

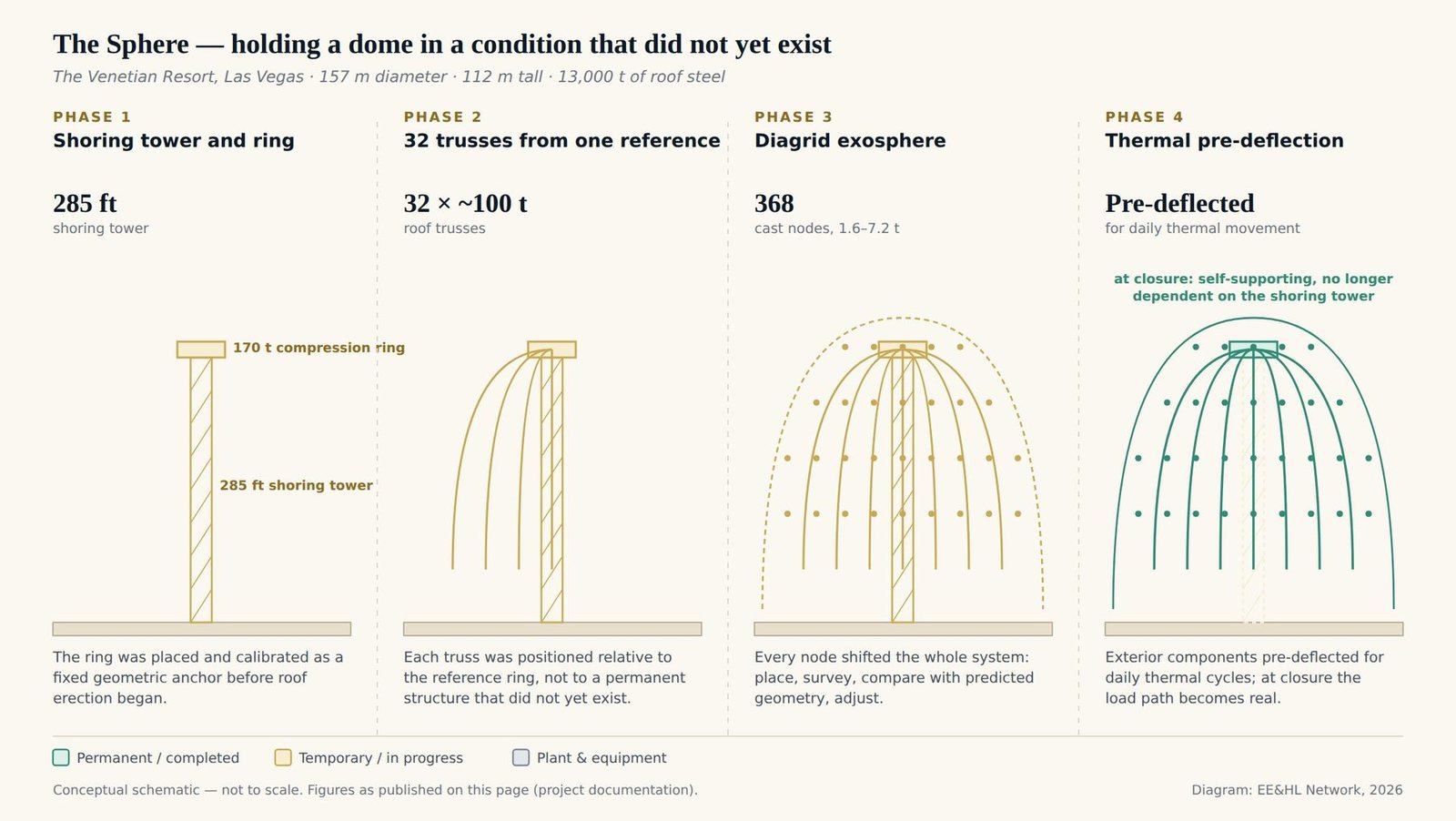

Phase 1 — The shoring tower and reference ring
A fixed point before there was a structure to fix it to
A 285-foot steel shoring tower was erected inside the volume. At its top, a 170-tonne compression ring was placed and calibrated as the central reference point before roof erection began — establishing a fixed geometric anchor for a structure that had no permanent load path yet.
Phase 2 — Sequential truss installation
32 trusses, built out from a single reference
From that fixed reference point, the domed roof took shape: 32 trusses, each weighing around 100 tonnes, installed sequentially — each one positioned relative to the reference ring rather than to a completed permanent structure that didn't yet exist.
Phase 3 — The diagrid exosphere
368 nodes, each one shifting the whole system
Once the inner structure was complete, the diagrid exosphere — 368 cast steel nodes, each between 1.6 and 7.2 tonnes — was built around it. Each new element shifted the whole system, requiring a continuous loop of placement, survey, comparison against predicted geometry, and adjustment, repeated across every node and every truss at every stage.
Phase 4 — Thermal pre-deflection
A time-dependent erection sequence
Engineering records note that exterior components were pre-deflected to absorb thermal movement from Las Vegas's daily temperature cycles — movement significant enough to push steel of this scale out of connection tolerance. Erection wasn't just geometric; it was time-dependent in a way that doesn't appear in the permanent structure's drawings.

Before that transition, everything was temporary. After it, the structure was complete in the only sense that matters for erection engineering.

The critical moment isn't visible in any photograph of the finished building: it's when the final elements engaged the compression ring and the load path became real, when the structure stopped depending on the shoring tower and started carrying its own weight. On most projects, geometry is fixed before erection begins. Here, it only became real at closure — making the Sphere a defining case for erection sequences where the structure's final shape isn't a starting assumption but an outcome the erection process has to earn.

For further reading on temporary structural states, see What is Temporary Works & Erection Strategy?

Related case studies: Singapore Sports Hub · Eiffel Tower · London Eye

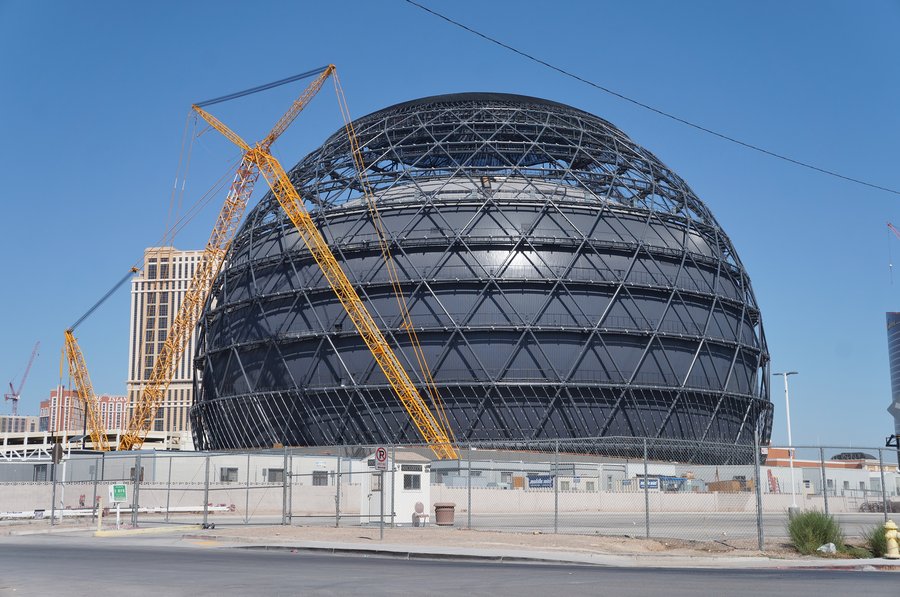

The Sphere at The Venetian in Las Vegas under construction, September 2022, showing its exposed geodesic steel structure with two large cranes alongside
The Sphere at The Venetian under construction, Las Vegas, September 2022. Resized from the original for web display.
Photo: SounderBruce, via Wikimedia Commons, CC BY-SA 4.0.

Sources: Sphere (venue) — construction chronology and the Demag CC-8800 crawler crane, shipped disassembled from Zeebrugge to Port Hueneme and moved to site on 120 tractor-trailers; The B1M — four concrete cores tied by roughly 9,700 tonnes of steel into tensioned ring beams carrying an 11,000-tonne roof, and the 18 days required to assemble the crane on site; ArchDaily — Populous as architect and opening chronology. Dimensions are published as 366 ft (112 m) high and 516 ft (157 m) wide. The “largest spherical structure” framing is widely used but contested: the venue is a geodesic dome rather than a true sphere, and some sources qualify the record on that basis.
