The Chenab Bridge stands 359 m above the river it crosses — roughly 35 m taller than the Eiffel Tower — carrying rail traffic across a Himalayan gorge in Seismic Zone V, where wind speeds can reach 266 km/h.

Conventional ground-based falsework was never an option here: the terrain made it structurally and logistically impractical at any reasonable cost. The answer was to erect the arch from both valley walls at once, using cable-supported methods throughout, and let the two halves meet in the air.

359 m
Height above river
467 m
Main arch span
915 m
Cable-crane span
120 yrs
Design life

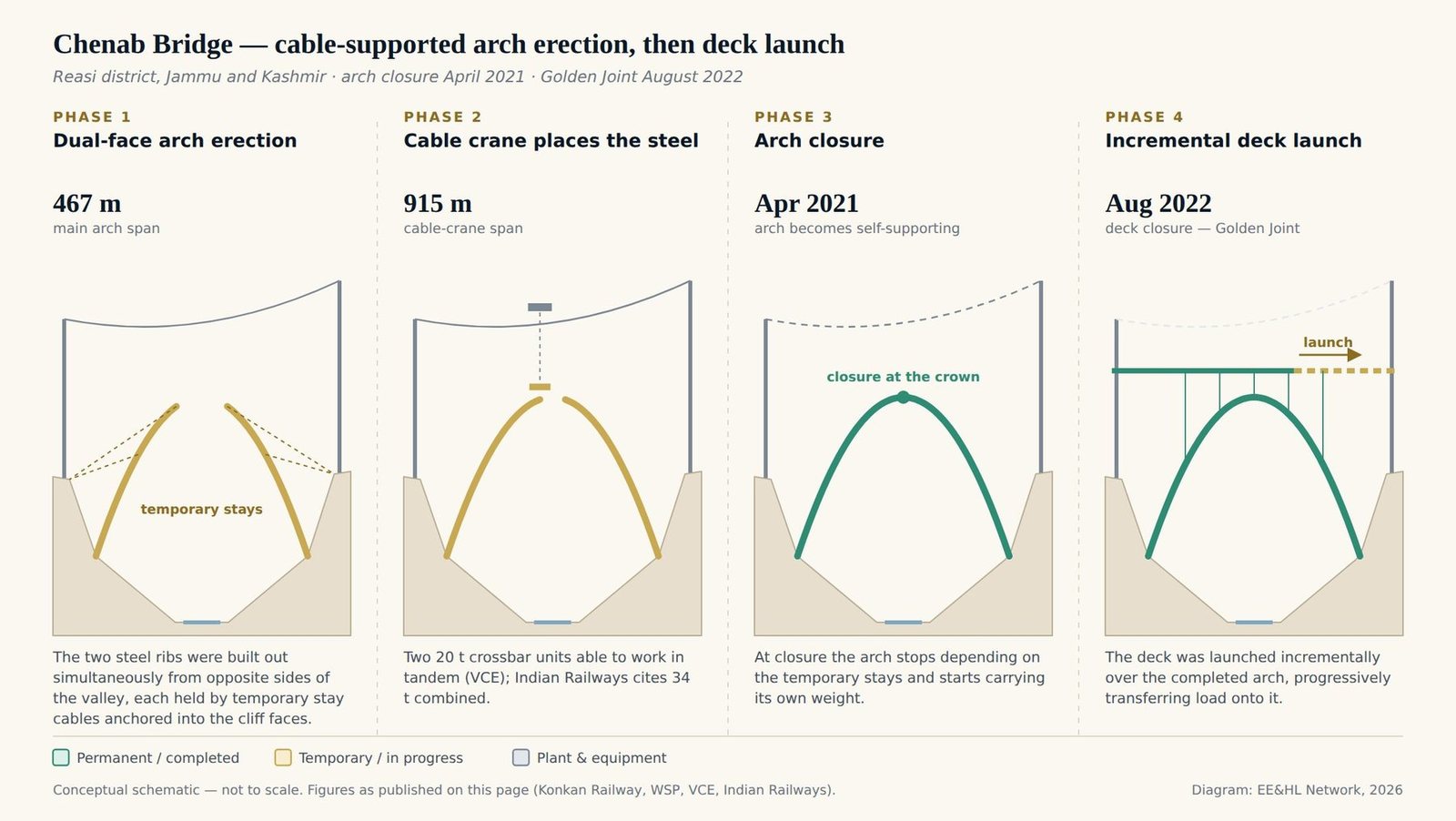

Phase 1 — Dual-face arch erection
Building out from both abutments
The two steel arch ribs were erected simultaneously from opposite sides of the valley, each stabilised by temporary stay cables anchored into the cliff faces until the ribs met at the crown.
Phase 2 — The cable-crane system
Positioning steel with no access from below
An overhead cable-crane system spanning 915 m carried and positioned 35-tonne steel blocks across the gorge, where they were assembled in situ into larger segments — the only viable method given the site's inaccessibility from below.
Phase 3 — Arch closure
The structure becomes self-supporting
The arch became self-supporting at closure in April 2021 — the moment the structure stopped depending on the temporary stay-cable system and started carrying its own weight.
Phase 4 — Incremental deck launch
The Golden Joint
Once the arch was self-supporting, the bridge deck was launched incrementally over it, progressively transferring load onto the completed arch. The deck's final closure — the "Golden Joint" — was reached in August 2022.

A record height, a 467 m arch span, and construction in remote, high-wind, high-seismic terrain with no direct access from below — one of the most demanding bridge-erection sequences ever executed.

The entire erection sequence relied on BIM-based planning and continuous geometry monitoring to hold alignment across the roughly year-long gap between arch closure and deck closure — in terrain where conventional survey access was often impossible. The Chenab Bridge redefined what's achievable in large-span arch erection, combining cable-supported lifting, stay-cable stabilisation, and real-time geometric control across one of the world's most difficult access environments.

For further reading on cable-supported and arch erection methods, see Erection Engineering in Bridge Construction and What is Strand Jacking?

Related case studies: Pelješac Bridge · Millau Viaduct · Oléron Viaduct

The Chenab Rail Bridge spanning the deep gorge of the Chenab River in Reasi district, Jammu and Kashmir, India, showing the steel arch and approach spans against the surrounding mountains
The Chenab Rail Bridge over the Chenab River gorge, Reasi district, Jammu and Kashmir. Resized from the original for web display.
Photo: Government of India, Ministry of Railways, via Wikimedia Commons, GODL-India.

Sources: Konkan Railway Corporation (Ministry of Railways, Government of India) — official project data for the 359 m height and 467 m arch span; WSP — design engineer's project record. Figures are reported as published.

Frequently Asked Questions

The Chenab Bridge stands 359 m above the Chenab River, making it the world's highest railway bridge — roughly 35 m taller than the Eiffel Tower.

The bridge crosses a steep Himalayan gorge in the Reasi district of Jammu & Kashmir, where the terrain made conventional ground-based falsework structurally and logistically impractical at any reasonable cost. Instead, the two steel arch ribs were erected simultaneously from both valley walls, each stabilised by temporary stay cables anchored into the cliff faces, and connected using an overhead cable-crane system rather than supports built up from the valley floor.

An overhead cable-crane system spanning 915 m carried 35-tonne steel blocks across the gorge and positioned them for assembly into larger segments in situ. This was the only viable method given the site's inaccessibility from below, and it operated in parallel from both abutments as the arch ribs advanced toward the crown.

The bridge was built in Seismic Zone V and designed to resist wind speeds of up to 266 km/h, with a 120-year design life. The main steel arch spans 467 m.

The arch became self-supporting at closure in April 2021, after which the deck was launched incrementally over it. The deck's final closure, referred to as the "Golden Joint," was reached in August 2022.
