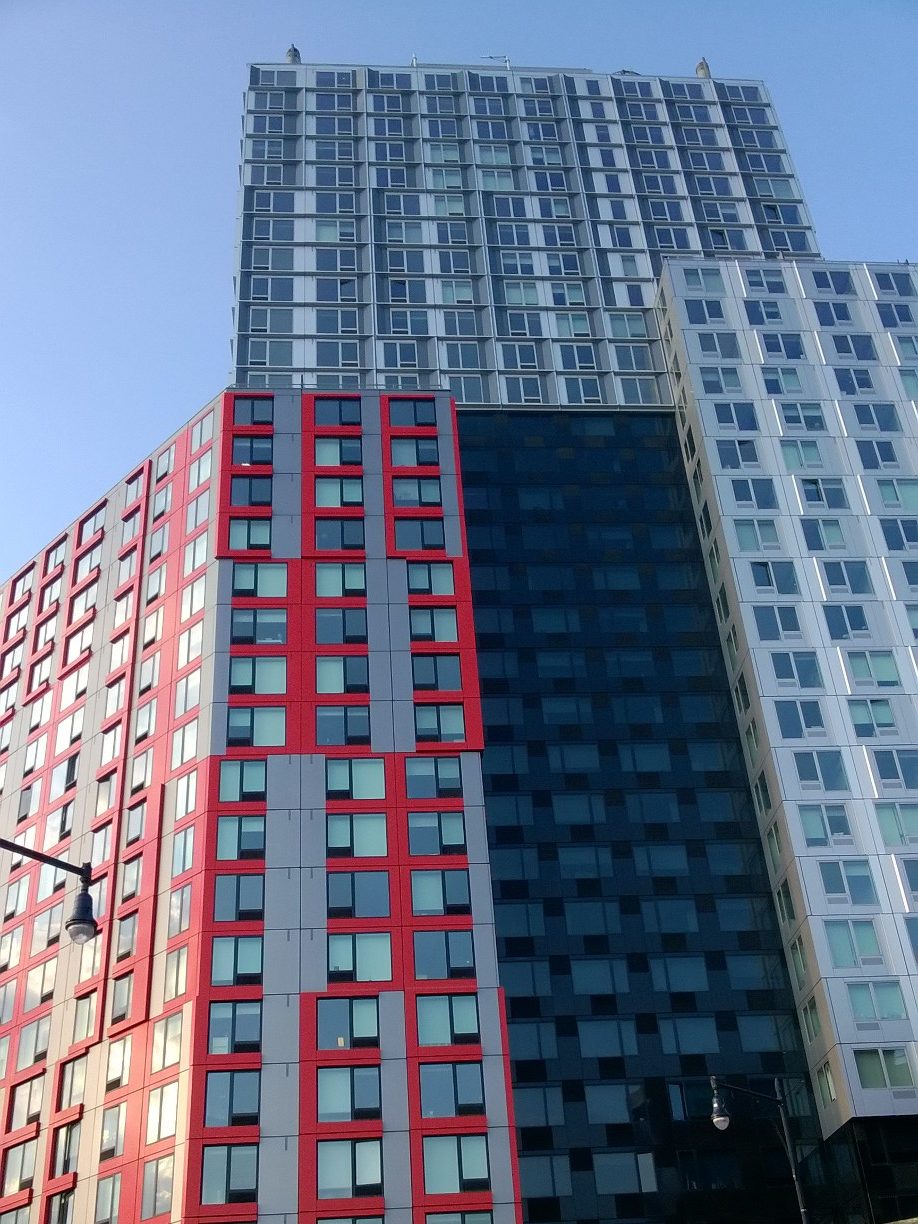

461 Dean Street promised to prove that high-rise modular construction worked at scale: factory-built steel modules, complete with electrical, plumbing, and finishes, stacked on site like building blocks in a fraction of conventional construction time.

At 32 storeys and 930 modules, it became the world's tallest modular building on completion in 2016 — and also became a case study in how small manufacturing tolerances, acceptable at low rise, can compound into serious problems as a stack climbs higher.

32
Storeys
930
Steel modules
363
Residential units
≈4 yrs
Construction duration

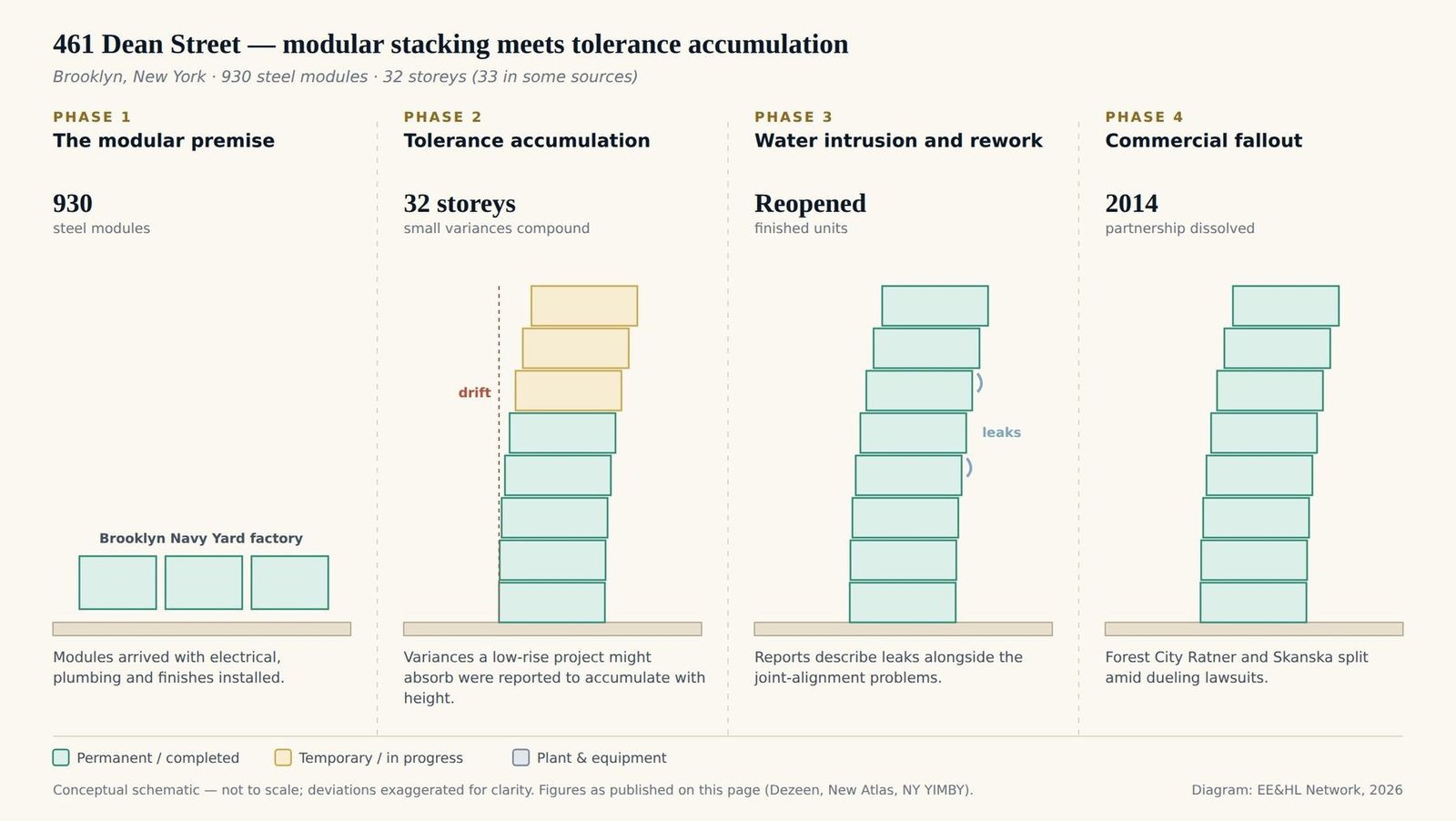

Phase 1 — The modular premise
Factory-built, site-stacked
Each of the 930 steel modules was manufactured at a dedicated factory in the Brooklyn Navy Yard, fitted out with electrical, plumbing, and finishes before ever reaching the site — the core promise of modular construction being that most of the work happens indoors, on a controlled schedule, ahead of erection.
Phase 2 — Tolerance accumulation at height
Small variances, compounding upward
As modules stacked toward 32 storeys, small dimensional tolerances in individual units — differences that a low-rise modular project might absorb without issue — reportedly compounded into alignment problems between module joints, a challenge widely described afterward as a lesson in tolerance accumulation at scale.
Phase 3 — Water intrusion and rework
Sealing problems reaching finished units
Reports on the project describe leaks and water intrusion tracing back to the same joint-alignment issues, requiring a number of already-finished units to be reopened and reworked — turning what modular construction promised as a controlled, factory-quality process into an active site remediation problem.
Phase 4 — Commercial fallout
A partnership that didn't survive the build
The original construction partnership between developer Forest City Ratner and contractor Skanska dissolved in 2014 amid dueling lawsuits, each side blaming the other for the delays and cost overruns. The litigation was reportedly settled confidentially in 2020, well after the building had opened.

A hard-won lesson in tolerance accumulation — the same small manufacturing variances that a low-rise modular project would never notice became a structural and commercial problem at 32 storeys.

Construction took roughly four years — reportedly close to double the originally promised timeline — with reported costs exceeding earlier estimates by about 26%, rather than delivering modular construction's promised savings. Forest City subsequently exited the modular construction business entirely, selling its factory and technology, while the remaining towers planned for the same development moved to conventional construction methods. 461 Dean Street remains a reference case for where modular construction's real engineering risk concentrates: not in building the modules, but in what happens when their small tolerances meet gravity, height, and the weather.

For further reading on modular installation methods, see Erection Engineering in Industrial Construction

Related case studies: citizenM Bowery · AC Hotel NoMad · The Clement Canopy

Sources: Dezeen — 930 steel modules fabricated at the Brooklyn Navy Yard, 359 ft (109 m) height; New Atlas; New York YIMBY. Storey counts are published as both 32 and 33, and apartment counts as 363 and 365, depending on the source. The tallest-modular claim dates to its 2016 opening.

Frequently Asked Questions

Completed in 2016, 461 Dean Street — also known as the B2 Tower — was, at 32 storeys, the world's tallest building constructed from stacked steel modules at the time, and remains the tallest modular building in the United States. It was built from 930 prefabricated steel modules manufactured at a factory in the Brooklyn Navy Yard.

Reports on the project describe alignment issues and water intrusion problems that emerged as modules were stacked to height, requiring numerous completed units to be reopened and reworked. Small dimensional tolerances in individual modules, described by one industry observer as a lesson in tolerance accumulation, compounded as the stack grew taller, creating sealing and alignment problems between module joints that a low-rise modular project would be far less likely to encounter.

Construction took roughly four years — reportedly close to double the originally promised timeline — and reported construction costs exceeded earlier estimates by approximately 26%, rather than delivering the modular approach's promised savings over conventional construction.

The original construction partnership between developer Forest City Ratner and contractor Skanska dissolved in 2014 amid dueling lawsuits, each side blaming the other for the delays; the litigation was reportedly settled confidentially in 2020. Forest City subsequently exited the modular construction business and sold its module factory and technology, while the remaining planned towers in the same development moved to conventional construction methods.
